About the Project
About the Imjin Parkway Widening & Roundabout Project

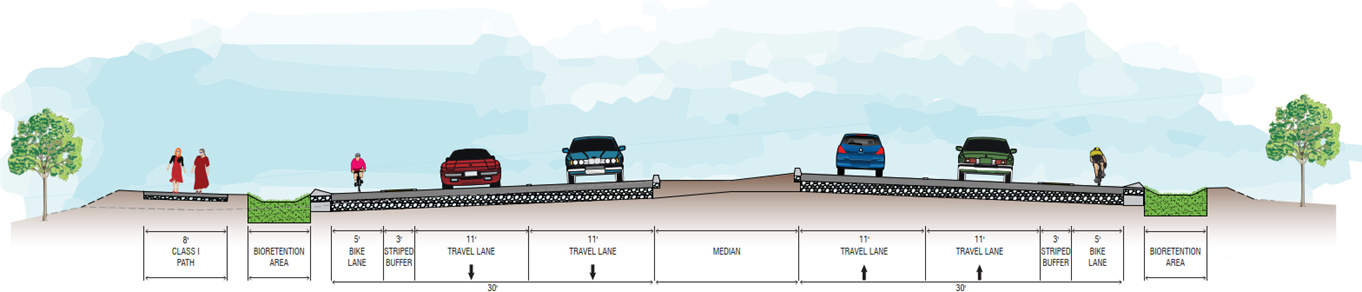

The City of Marina is performing improvements along the Imjin Parkway corridor, from Imjin Road to Reservation Road. The approximately 1.7 miles of roadway improvements include expanding the existing two lanes to four lanes, constructing four new roundabouts at intersections, and modifying the existing signal at the Reservation/Imjin intersection. Project amenities include class 2 bike lanes, a multi-use pathway, crosswalk beacons, storm-water improvements, street lighting, artwork, and landscaping.
Simulation & Renderings
Phases of Construction
Schedule
Funding
Project Documents
Imjin Parkway Widening & Roundabout Project Simulation
Imjin Parkway Widening & Roundabout Project Renderings
Phases of Construction
The Imjin Parkway Widening & Roundabout Project is split up into three phases to minimize construction impacts along the roadway as well as increase efficiencies to complete the project as quickly as possible.

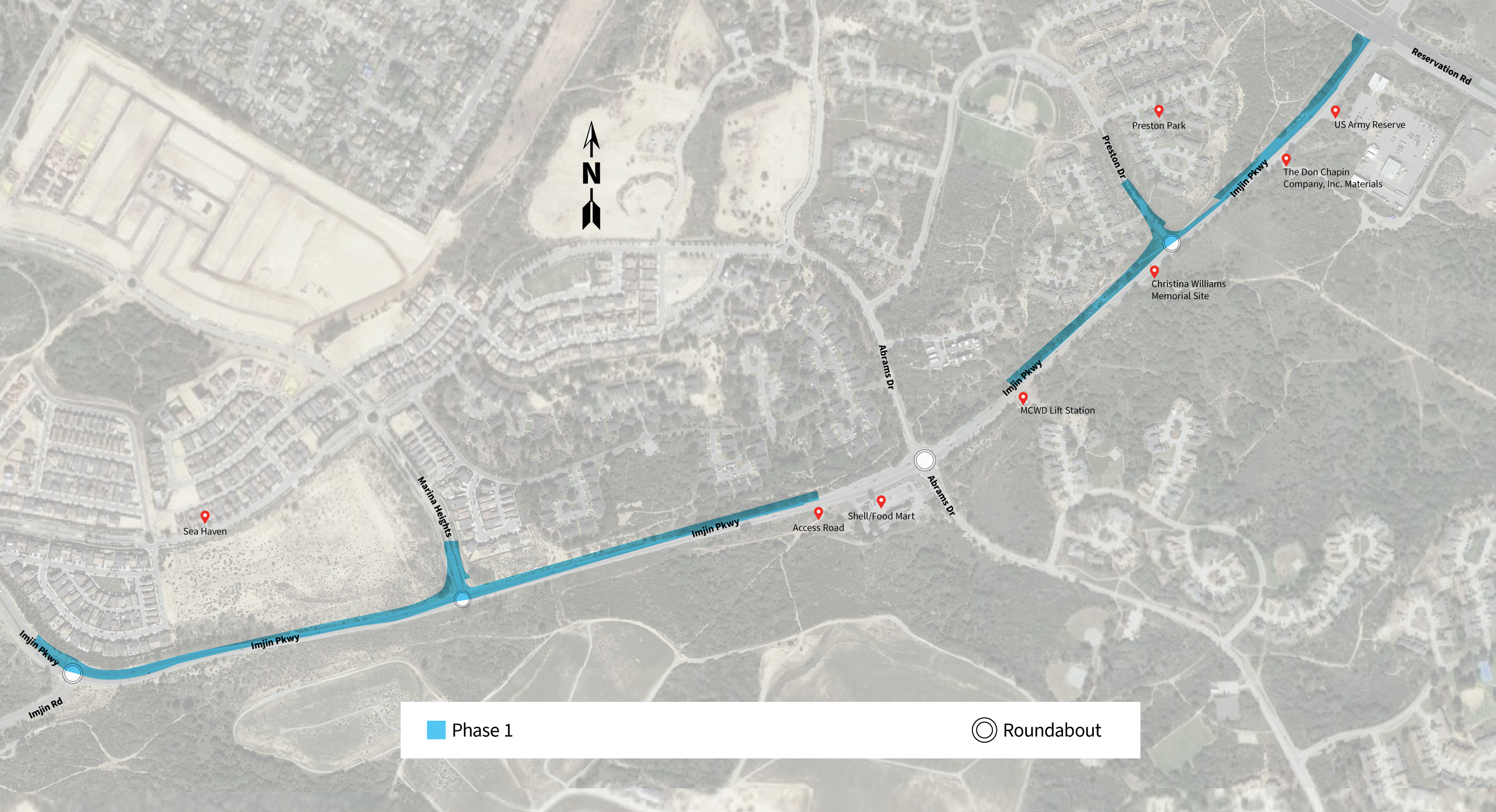

Phase 1—North Side of Roadway (Westbound Towards Highway 1)
Clearing, Grubbing, and Demolish Existing Roadway
Earthwork and Grading
Drainage, Utilities, Irrigation, and Lighting
Retaining and Sound Walls
Roadway Paving and Temporary Striping
Landscaping
North Side of Roadway Roundabout Construction
- Preston Avenue
- Abrams Road
- Marina Heights Road
- Imjin Road
Driveway Access Will Be Maintained Throughout Construction

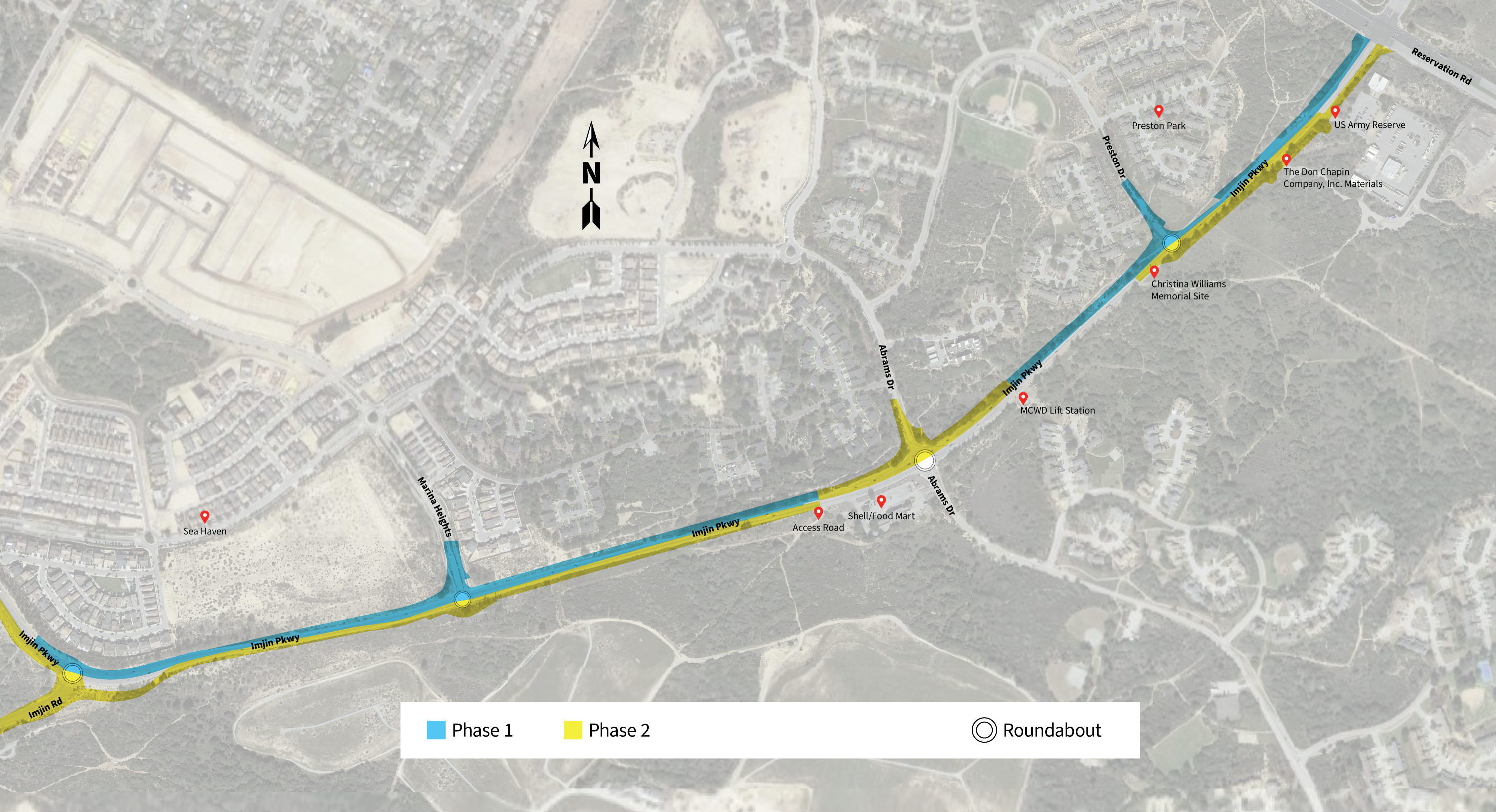

Phase 2—South Side of Roadway (Eastbound Towards Reservation Road)
Clearing, Grubbing, and Demolish Existing Roadway
Earthwork and Grading
Drainage, Utilities, Irrigation, and Lighting
Roadway Paving and Temporary Striping
Landscaping
South Side of Roadway Roundabout Construction
- Imjin Road
- Marina Heights Road
- Abrams Road
- Preston Avenue
Driveway Access Will Be Maintained Throughout Construction

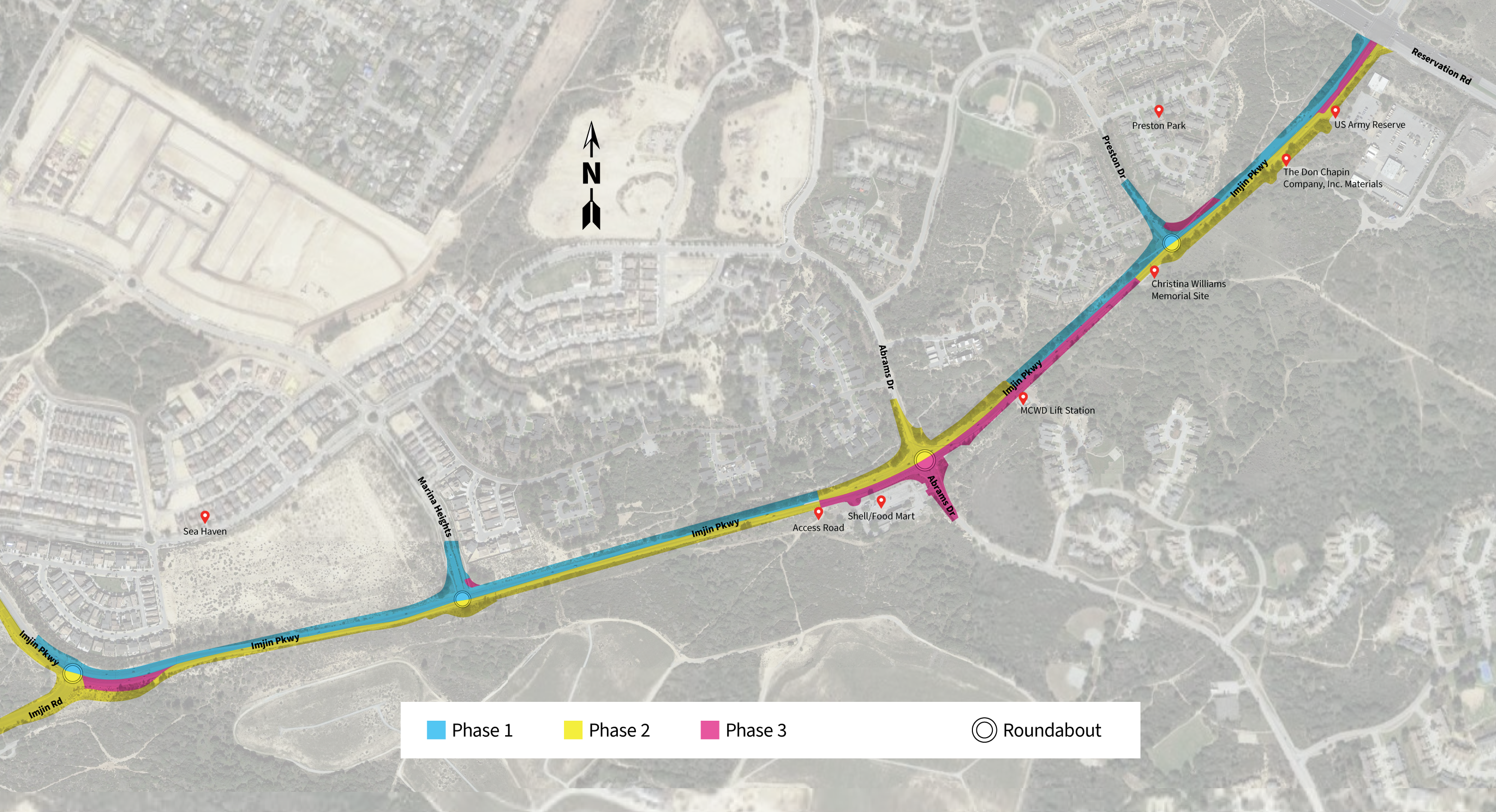

Phase 3—Miscellaneous Roadwork
Demolish Temporary Paving
Roadway Paving and Temporary Striping
Drainage, Utilities, and Lighting
Grading
Driveway Access Will Be Maintained Throughout Construction

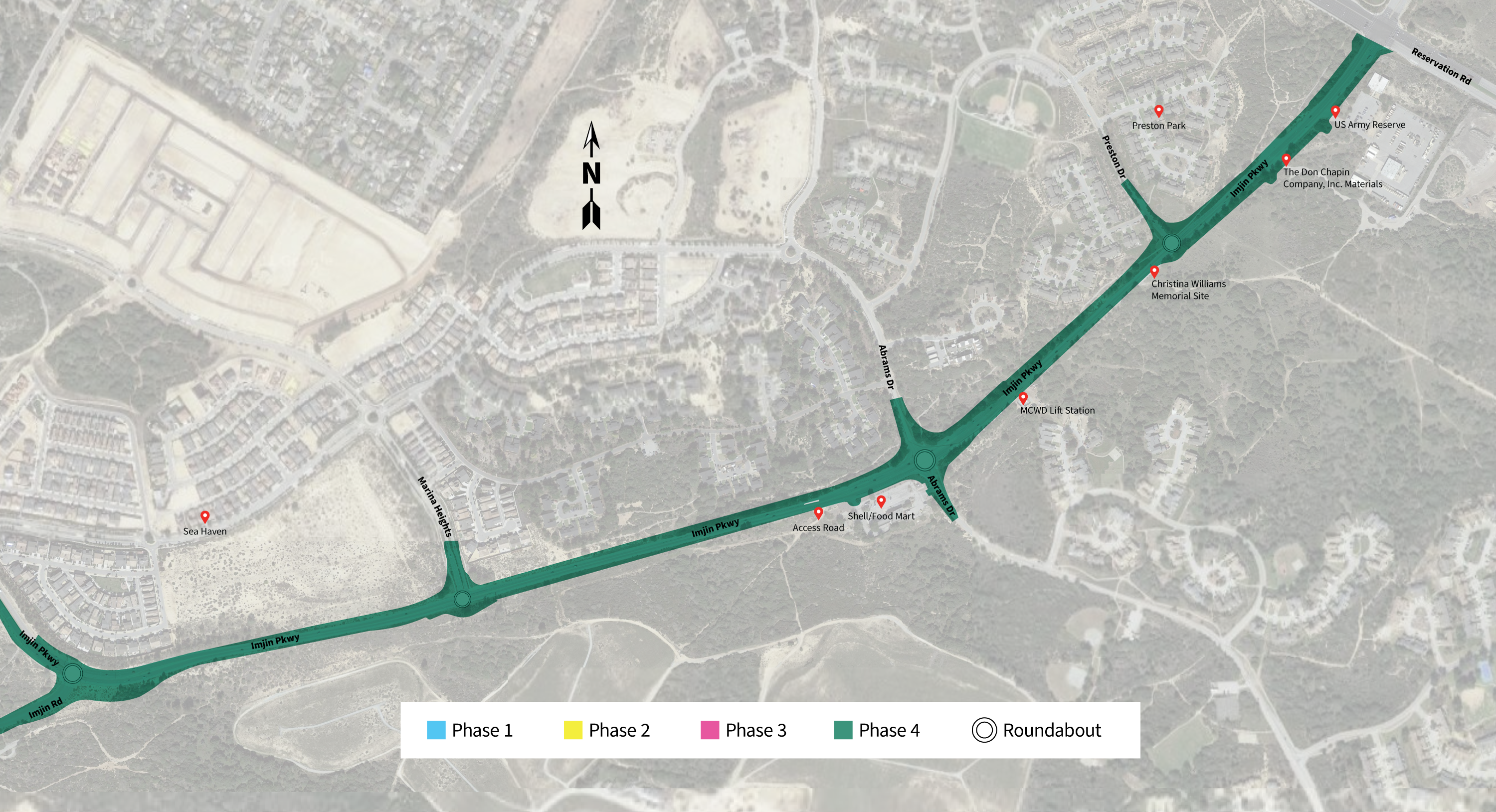

Phase 4—Final Paving and Striping
Final Paving (Top Lift) and Striping
Driveway Access Will Be Maintained Throughout Construction
Schedule
Due to the number of agencies providing approvals for environmental protections and various utility companies involved, the Imjin Parkway Widening & Roundabout Project is anticipated to begin construction activity in December 2023. Full completion of construction is expected to take approximately two years.
Construction Begins December 2023
Completion in Late 2025
Project Funding

(Development Impact Fees)


(Local Partnership Program)
